Active Projects Report - April 3, 2026

Los Rios CCD | Planning and Construction

ARC 2025 BSO Office Remodel
PM: Blake Architect: Moniz Architecture Contractor: PRO BUILDERS
Scope: Campus requested and funded remodel of area within the Business Services Office including ADA upgrades.
Weekly Update: 2026.04.01- 1) Closeout stage, final retention pay application and Change Order has been processed.
Tenative Schedule Start Months Finish % Complete

Prelim Plans Mar 2025 1 Apr 2025
Approvals Apr 2025 1 May 2025
Working Drawings May 2025 1 Jun 2025
Approvals Jun 2025 1 Jul 2025
Bid and Award Jul 2025 1 Aug 2025
Construction Aug 2025 4 Dec 2025
Campus Move-in Dec 2025 1 Jan 2026
ARC 2025 Child Development Center Shade Structure
PM: Uhlmeyer Architect: Architechnica Contractor:
Scope: Project to replace old failing shade structures at CDC.
Weekly Update: 3/26 - waiting on PO - Site concrete to be bid in early April 3/10 - Negotiating Source well Contract with Vender - Construction schedule is July 21 thru August 22 2/23 - Preparing Site Concrete Bid Package Onsite meeting to discuss options 10/2 DSA Submittal 8/28 - OTC 9/5 Proximity issues with Priority Shade &%% plans received for review/approval 7/30/2025 Concept Drawing Received 5/27/2025 & shared with Campus 6/4 Design "Kick Off" meeting held on 5/13/2025
Tenative Schedule Start Months Finish % Complete
Prelim Plans May 2025 2 Jul 2025 100%
Approvals Jul 2025 1 Aug 2025 100%
Working Drawings Aug 2025 4 Dec 2025 100%
Approvals Dec 2025 2 Feb 2026 100%
Bid and Award Feb 2026 3 May 2026 75%
Construction May 2026 4 Sep 2026
Campus Move-in Sep 2026 1 Oct 2026
ARC 2025 Natomas Key and Card Access Upgrade
PM: Blake Architect: N/A Contractor:
Scope: This project has responsibility to provide and install physical door hardware both electrified and non-electrified in Natomas Center Phase 1 building. This project will also install owner provided cylinders.
Weekly Update: 2026.04.01 - Low voltage installation is substantially complete and waiting for hardware to be installed before it is functional; hardware survey is complete and being prepared to send for quotes; will request quotes for installation once hardware has been ordered and delivery date is known.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Mar 2025 3 Jun 2025 100
Approvals Jun 2025 2 Aug 2025 100
Working Drawings Aug 2025 1 Sep 2025 100
Approvals Sep 2025 2 Nov 2025 100
Bid and Award Nov 2025 1 Dec 2025 50
Construction Dec 2025 2 Feb 2026
Campus Move-in Feb 2026 1 Mar 2026

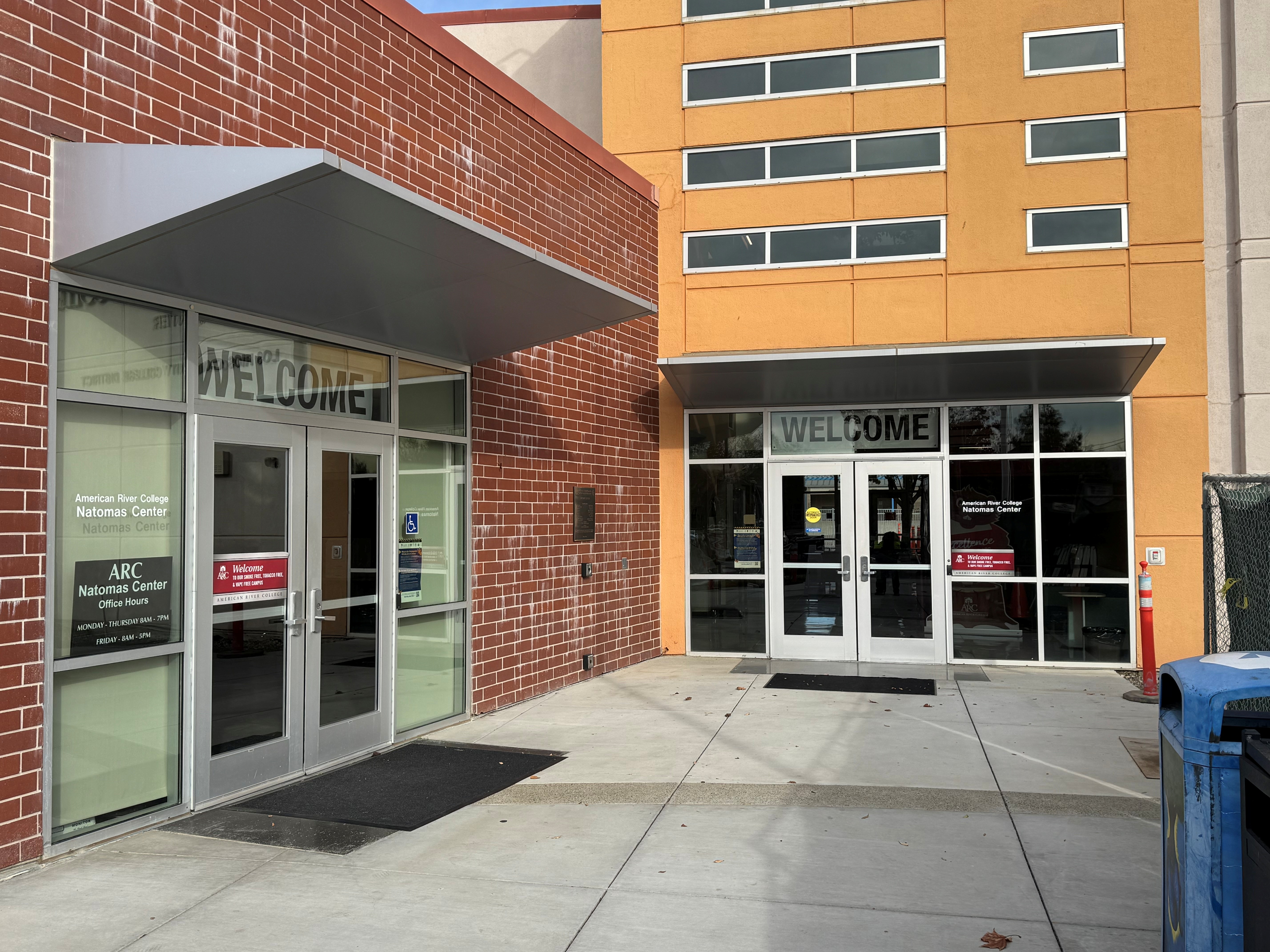

Natomas Ph 1
ARC 2025 Softball Scoreboard Replacement
PM: Uhlmeyer Architect: Verdi Design Contractor:
Scope: Campus purchased new scoreboard for the softball field. The new scoreboard does not match the size of the scoreboard it is replacing and requires design.
Weekly Update: 3/26 - Project fees check has been submitted to DSA 3/19 - 50% Set submitted to DSA - DSA Check has been requested 2/23 - SEOR is working with manufacturer's SEOR Pending DSA existing columns will work with modifications
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2025 3 Mar 2026 100%
Approvals Mar 2026 0 Mar 2026 100%
Working Drawings Mar 2026 4 Jul 2026
Approvals Jul 2026 0 Jul 2026
Bid and Award Jul 2026 2 Sep 2026
Construction Sep 2026 2 Nov 2026
Campus Move-in Nov 2026 0 Nov 2026
ARC 2026 Snack Bars
PM: Meyer Architect: Contractor:
Scope: Due Diligence Study to determine necessary requirements to gain Health Dept approval to operate snack bars across campus.
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Mar 2026 0 Mar 2026
Approvals Mar 2026 0 Mar 2026
Working Drawings Mar 2026 0 Mar 2026
Approvals Mar 2026 0 Mar 2026
Bid and Award Mar 2026 0 Mar 2026
Construction Mar 2026 0 Mar 2026
Campus Move-in Mar 2026 0 Mar 2026
ARC Davies Hall Modernization
PM: Blake Architect: Lionakis Contractor:
Scope: Demo and replace Davies Hall
Weekly Update: 2026.04.01- 1) DD Phase, working with Design team on estimate. 2) Next DD Design FM/I.T./Site meeting scheduled 4/8/26. 3) DSA Pre-App Meetings Scheduled for 4/2/26. 4) Distech Controls Meeting on 3/24 went well, working with FM and design teams on developing Division 25.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Sep 2025 6 Mar 2026
Approvals Mar 2026 1 Apr 2026
Working Drawings Apr 2026 6 Oct 2026
Approvals Oct 2026 8 Jun 2027
Bid and Award Jun 2027 3 Sep 2027
Construction Sep 2027 18 Mar 2029
Campus Move-in Mar 2029 2 May 2029
ARC NEC Phase II & III
PM: Besne Architect: LPA Inc Contractor: JOHN F OTTO, INC
Scope: This Project builds a new 31,077 assignable square feet (asf) (49,800 gross square feet) instructional facility adjacent to the existing American River College Natomas Center building. The new building will provide space for instruction in general education, biology and chemistry and provides ADA access compliance and adequate HVAC, power, technology and lighting systems to support these instructional programs. This includes 5,610 asf of lecture space, 16,441 asf of lab space and 9,026 asf of office/admin and miscellaneous support space.
Weekly Update: Construction completed as of 02/20/2026. NOC issued. Addressing warranties and punch items ongoing!
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2019 9 Aug 2020 100%
Approvals Aug 2020 4 Dec 2020 100%
Working Drawings Dec 2020 6 Jun 2021 100%
Approvals Jun 2021 14 Aug 2022 100%
Bid and Award Aug 2022 9 May 2023 100%
Construction May 2023 31 Dec 2025 100%
Campus Move-in Dec 2025 3 Mar 2026 75%

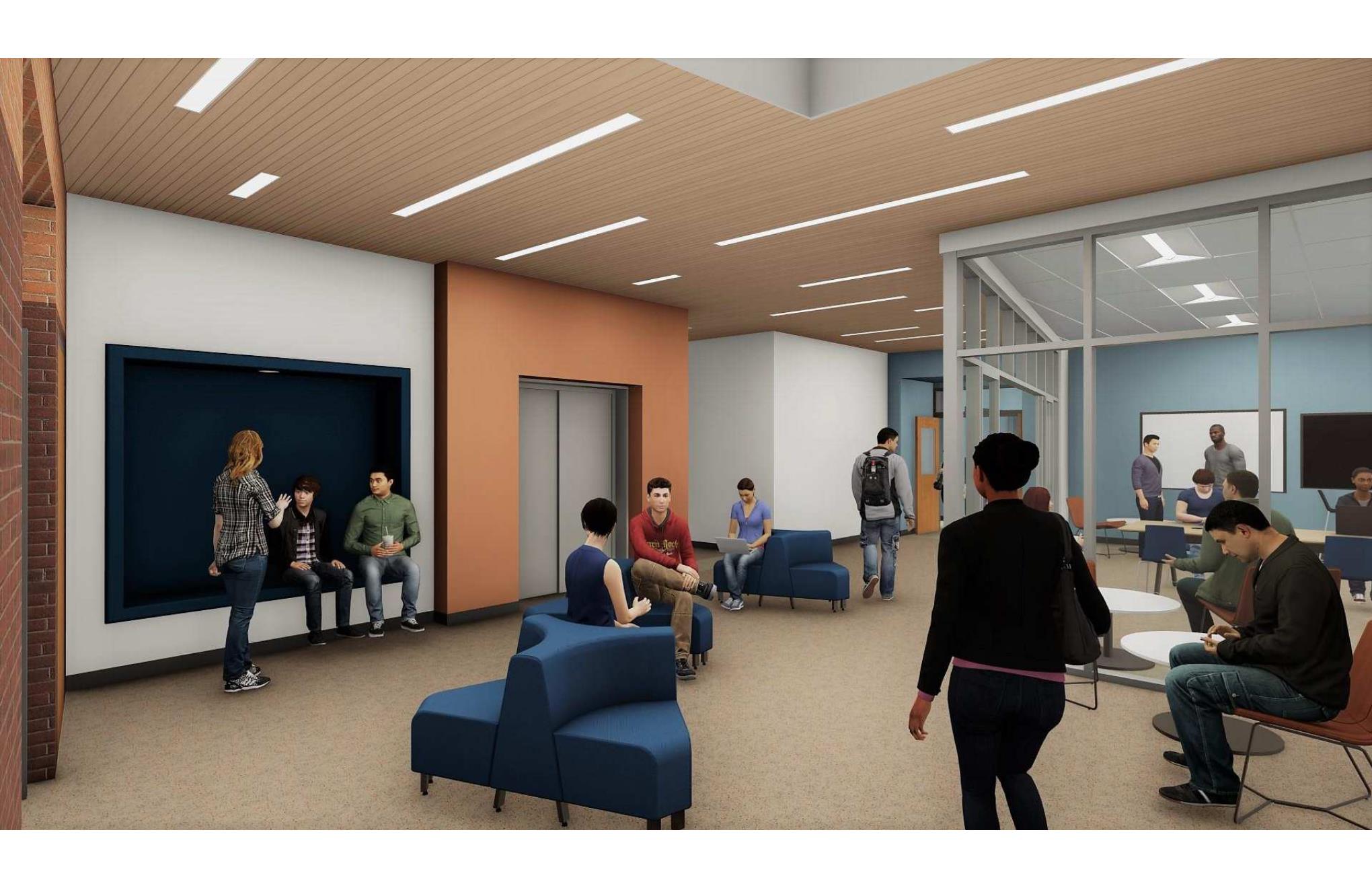

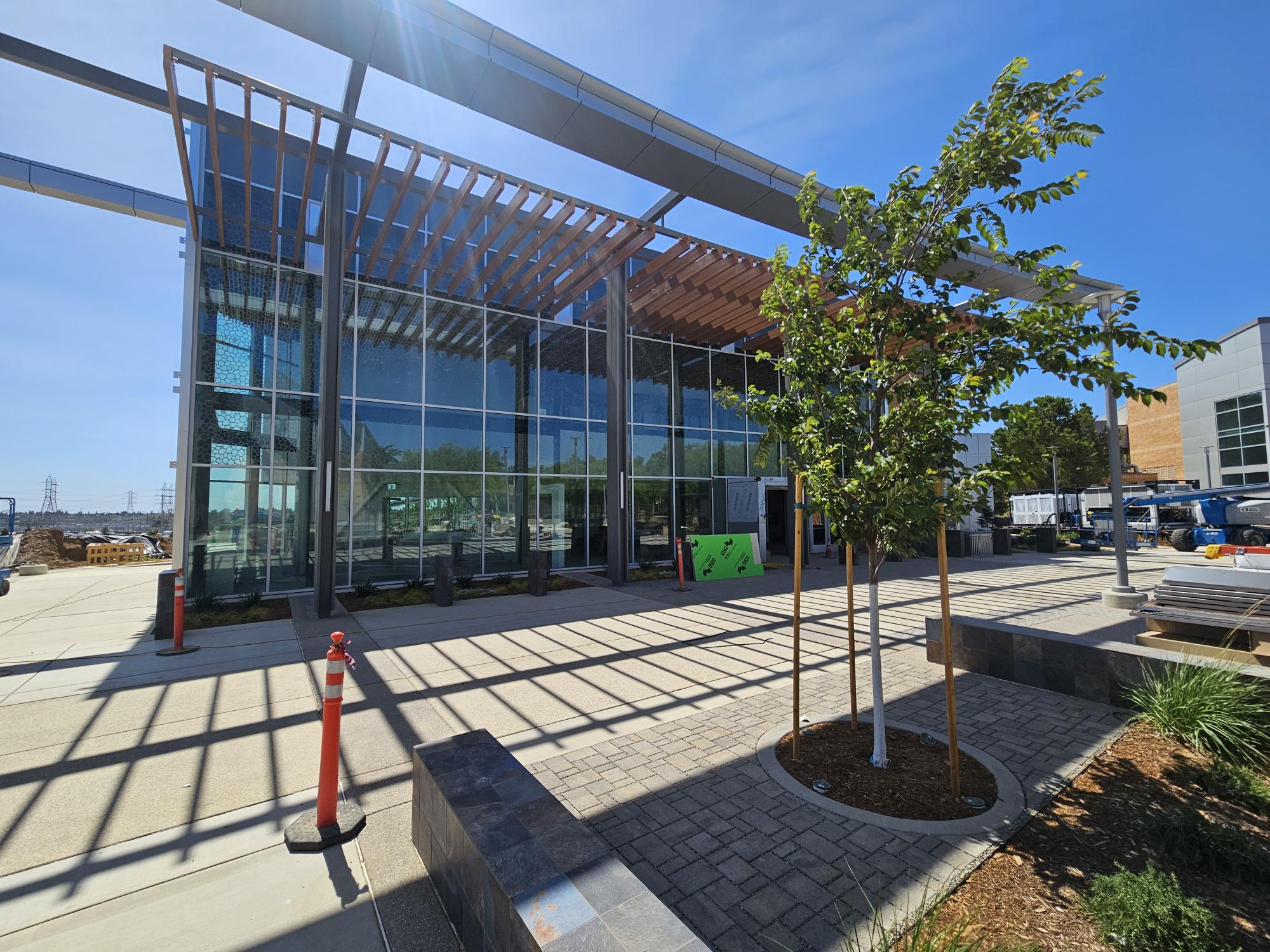

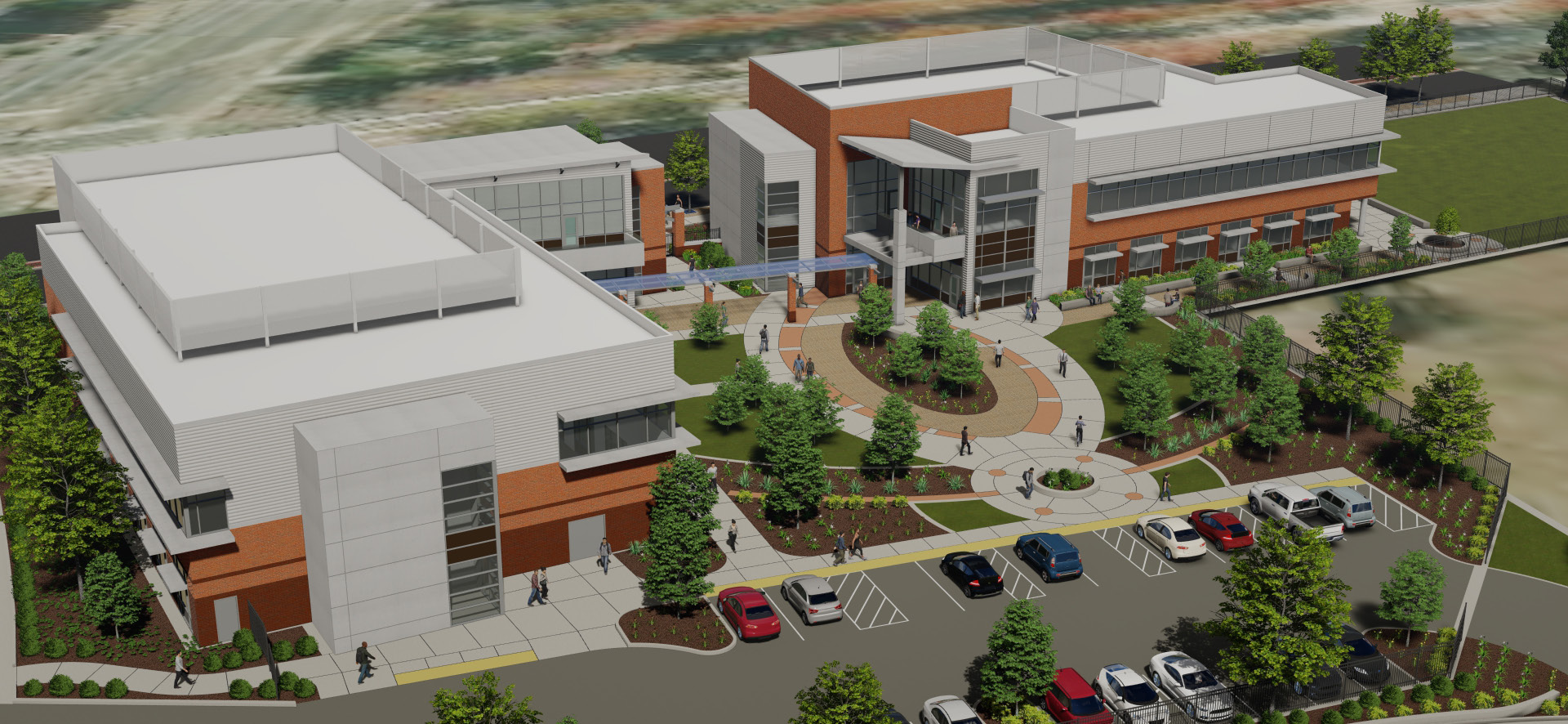

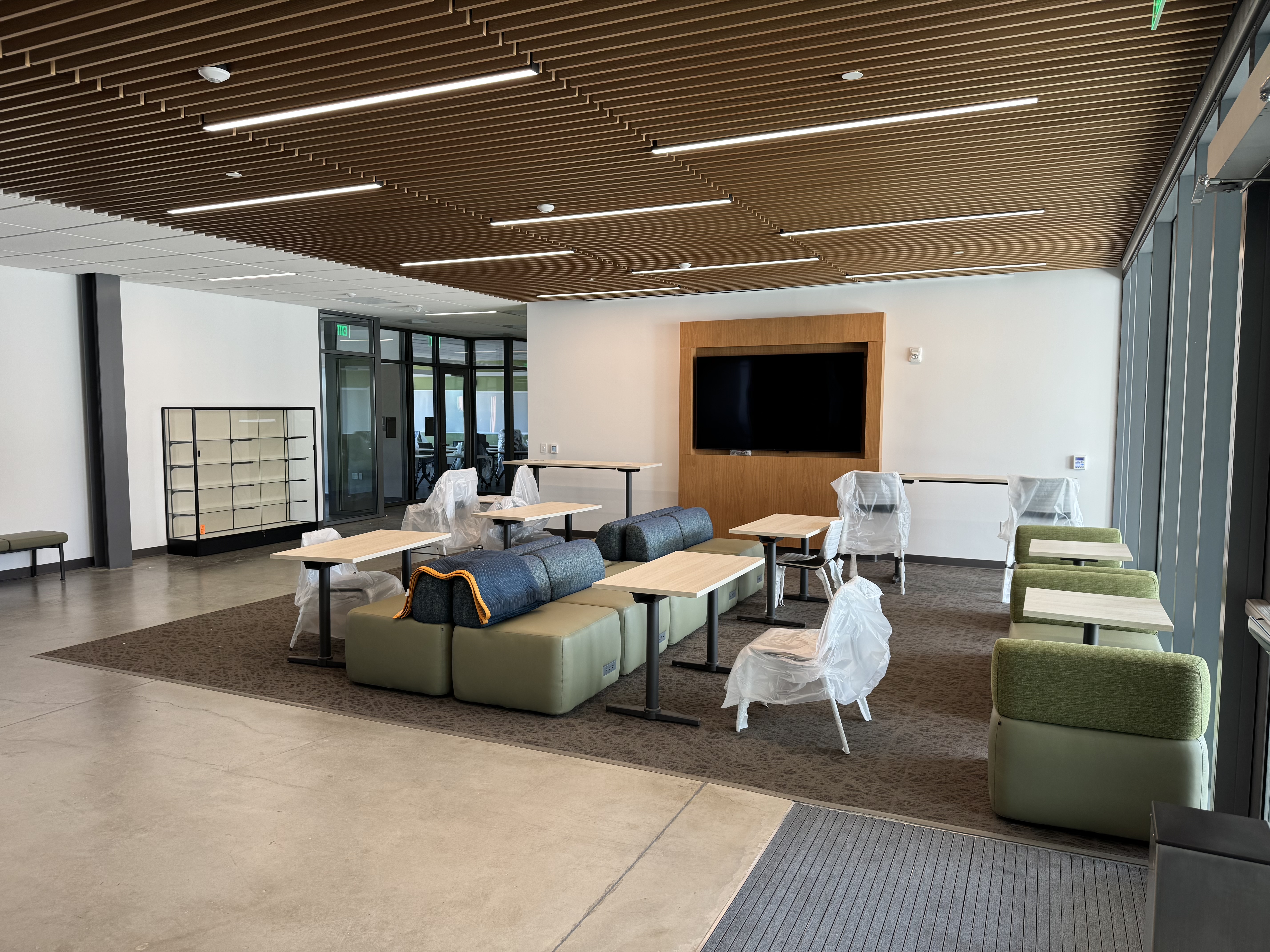

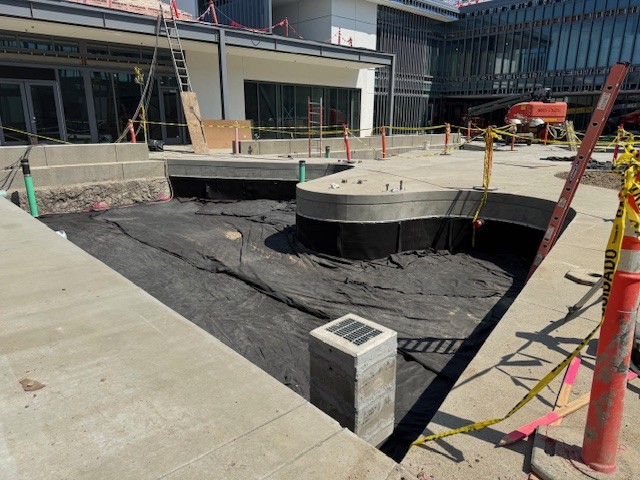

Collaboration 1st Floor

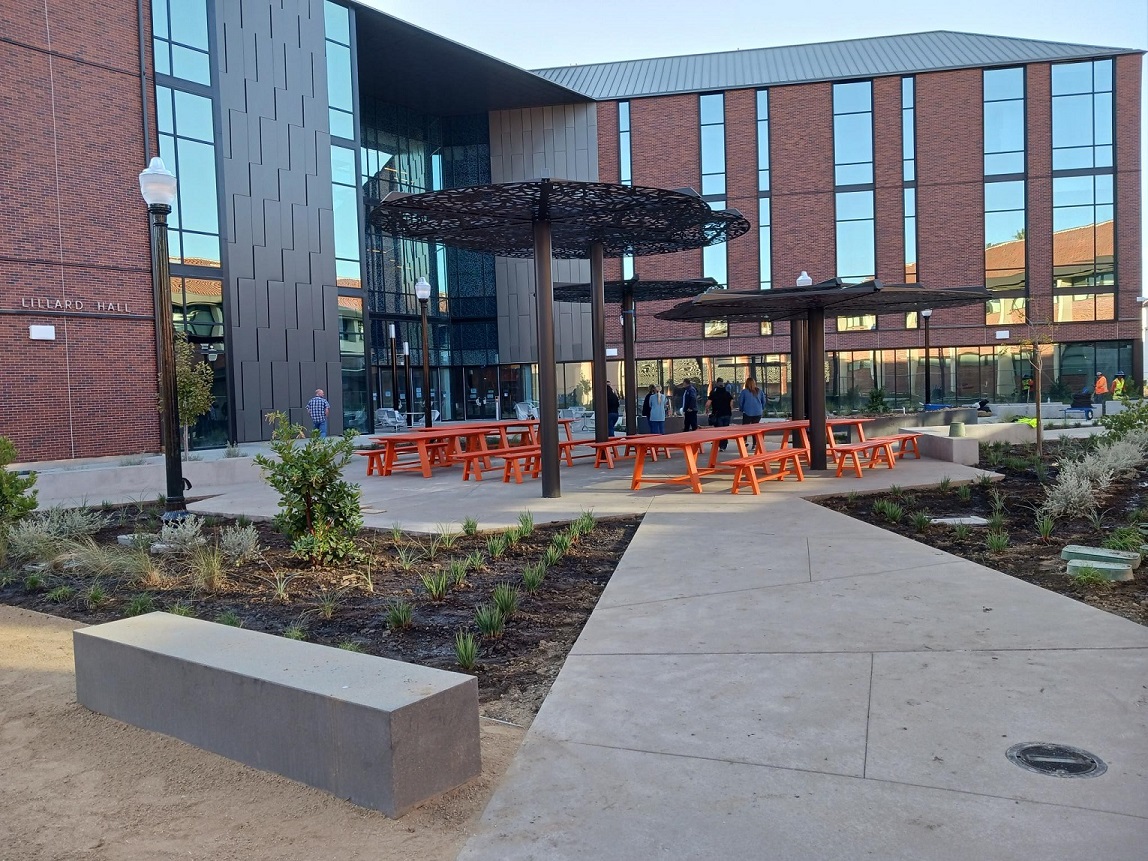

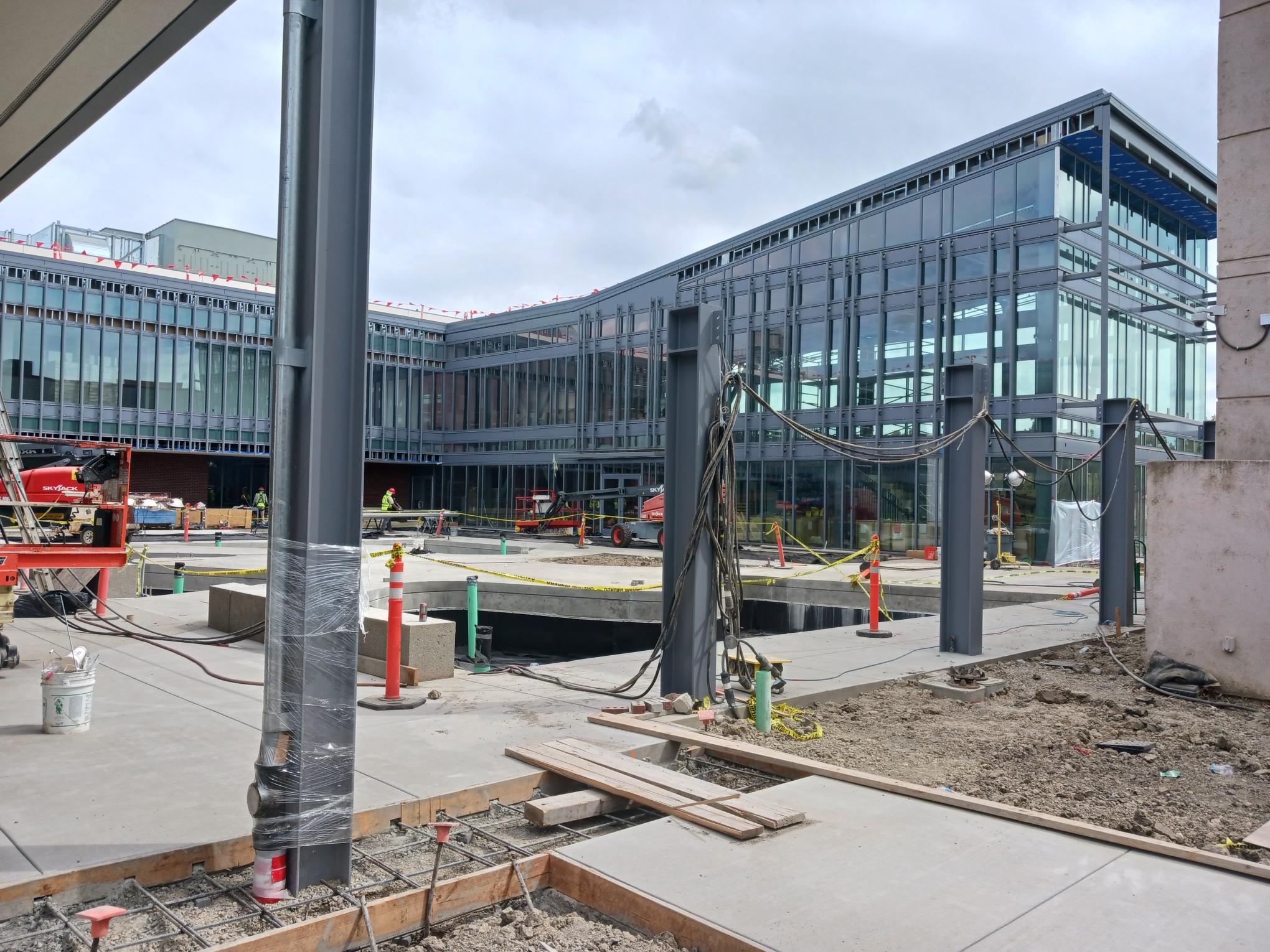

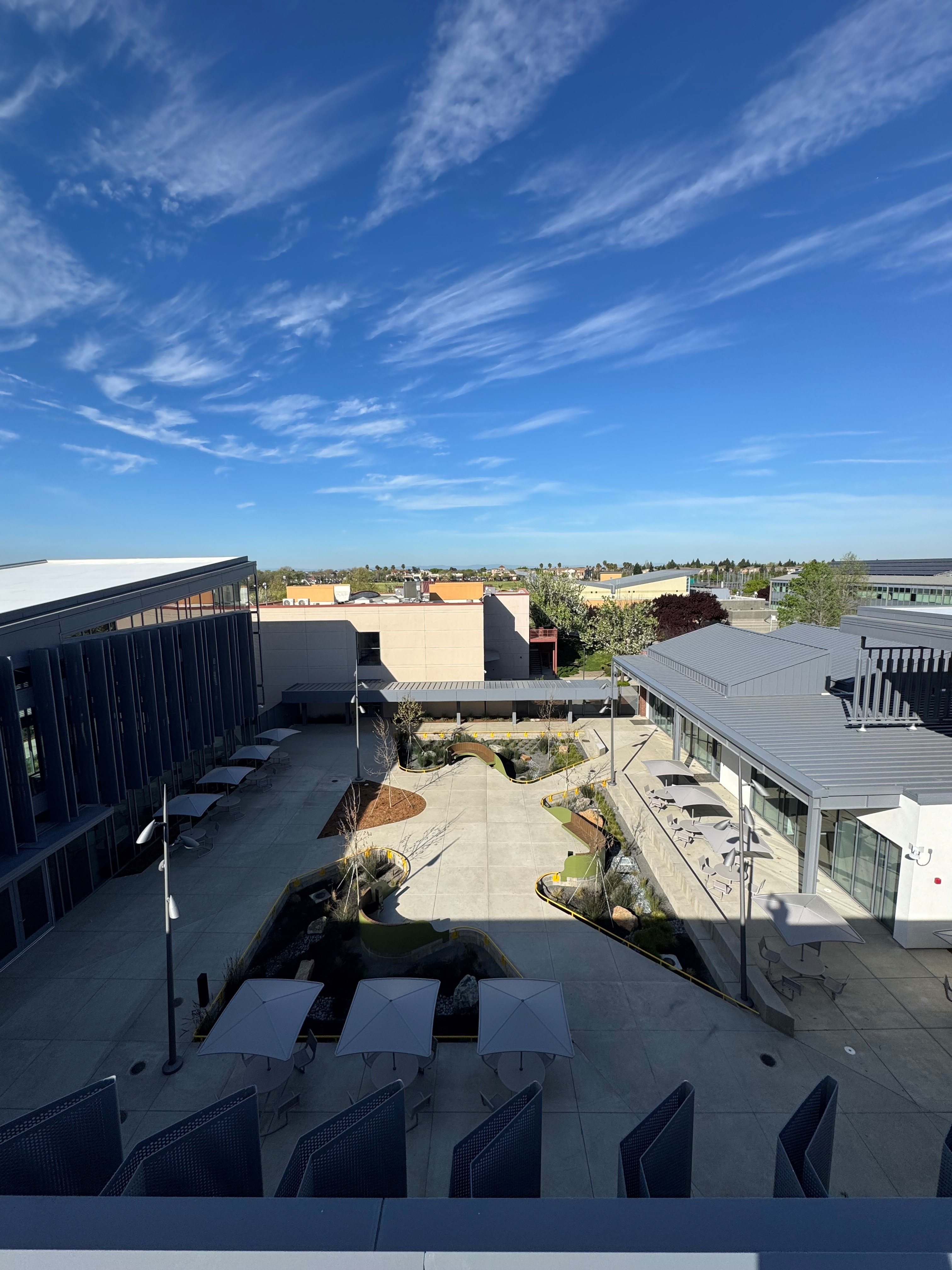

Courtyard
ARC NEC TAP II & III Offsite Parking
PM: Uhlmeyer Architect: Kier+Wright (civil) Contractor: WESTERN ENGINEERING CONTRACTORS, INC
Scope: Construction of off site parking to support NEC phase II and III. Location of parking lot will be across Via Ingoglia, a short walk to the Natomas Center, and provide approximately 250 stalls. The parking lot is on a shared property with a soon to be constructed softball field for Inderkum HS.
Weekly Update: This project is 100% complete, Jen Mellor (NUSD) has been allowed to open and close the parking lot per HS Softball needs. .................................................................................................................................................................................................. precision striping PO issued - work to be completed week of 5/1 Zellars Concrete on site to complete City Side Walk Restoration work for City Final week of 5/1
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2019 3 Feb 2020 100%
Approvals Feb 2020 9 Nov 2020 100%
Working Drawings Nov 2020 6 May 2021 100%
Approvals May 2021 6 Nov 2021 100%
Bid and Award Nov 2021 4 Mar 2022 100%
Construction Mar 2022 8 Nov 2022 100%
Campus Move-in Nov 2022 1 Dec 2022 100%

Paving and Landscaping completed looking towards Library

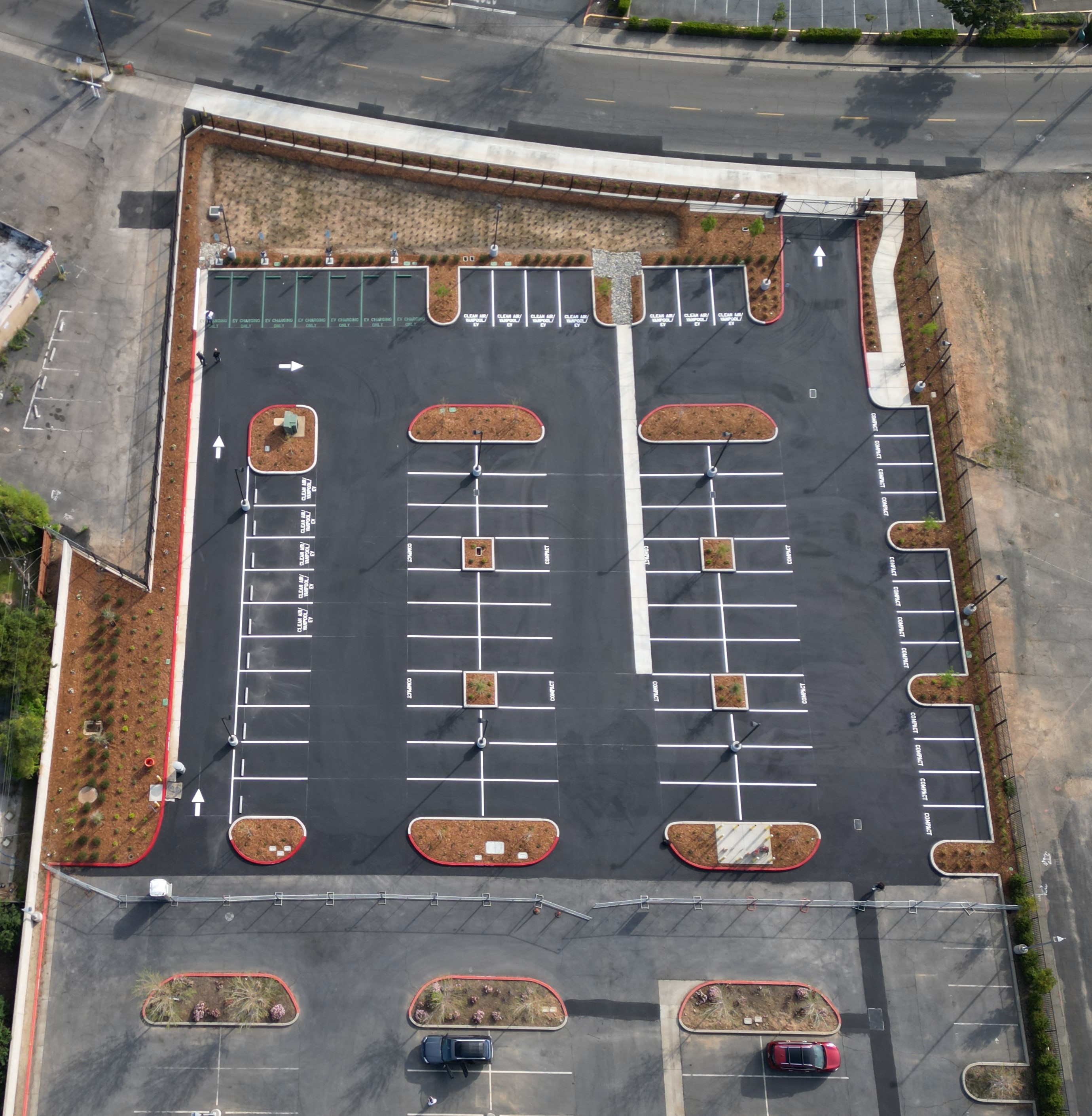

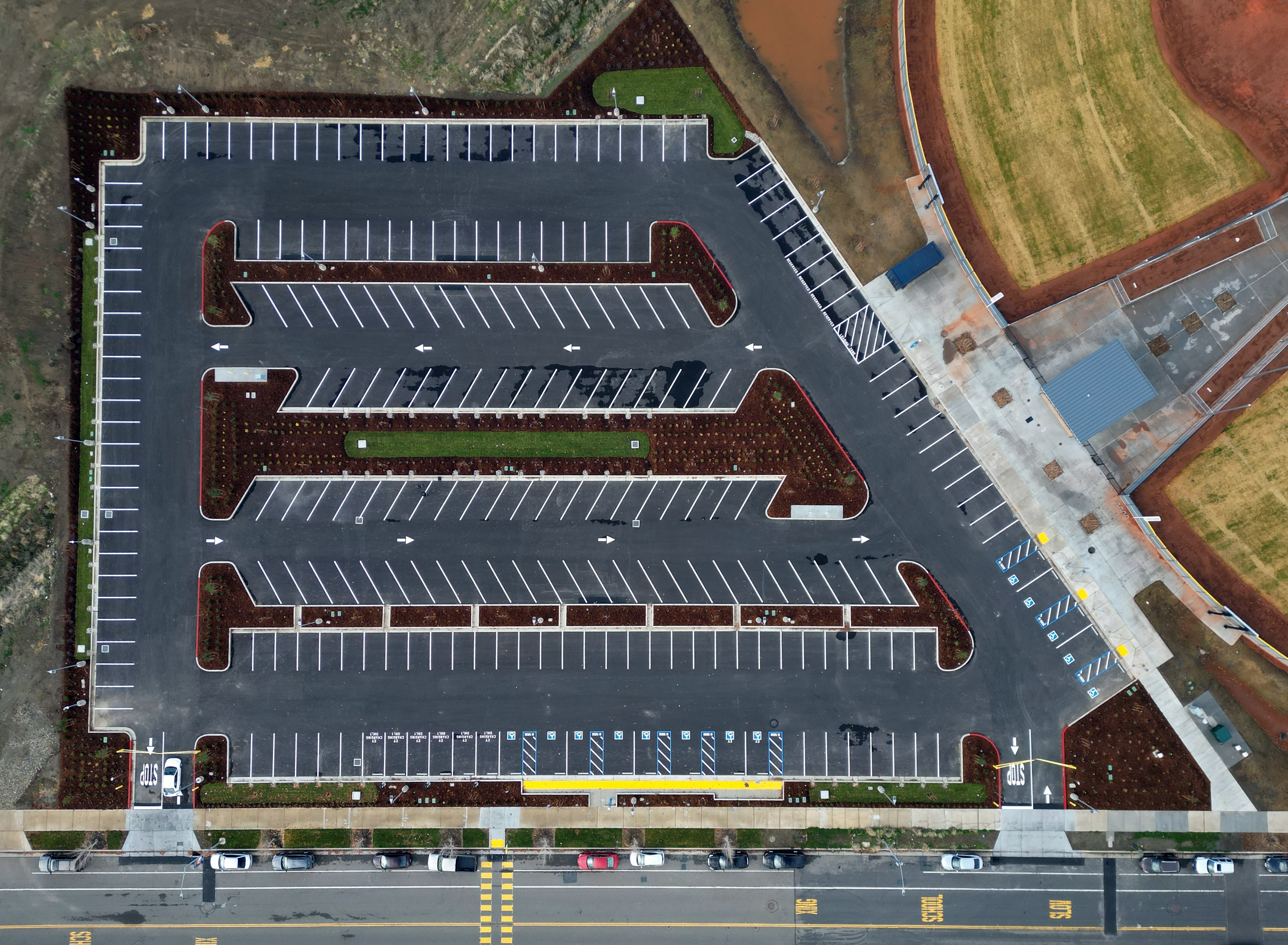

Aerial View of Completed Lot
ARC Portable Village 1 & 2 Refresh
PM: Uhlmeyer Architect: HED Contractor:
Scope: Costs related to the closure of Davies Hall and Refresh of existing Portable Villages 1 & 2 to support instruction due to closure.
Weekly Update: 3/26 - waiting on PO 3/19 - College Buys Contract(s) have been Submitted for PV1 Restrooms & PV 1 & 2 Refresh - Schedule start 5/26 3/10 - College Buys Contract has been negotiated and under review for PV1 Restrooms & PV 1 & 2 Refresh 2/23 - PV1 Restroom Project approved by DSA. Project will bid vis College Buys. 2/23 - PV1 & PV2_Project will bid vis College Buys. PV3 has been cancelled and replaced with upgrades to PV1, PV2. Walked site 09/15 to review scope. Issued estimate at approx. $1.3M. Second site walk with design team on 10-24. Received 75% CDs 12/2 for review and expected CDs issued Dec 19th. Campus approved 75% set.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2023 25 Dec 2025 100
Approvals Dec 2025 1 Jan 2026 100
Working Drawings Jan 2026 1 Feb 2026 100%
Approvals Feb 2026 1 Mar 2026 100%
Bid and Award Mar 2026 2 May 2026 100%
Construction May 2026 3 Aug 2026
Campus Move-in Aug 2026 1 Sep 2026
ARC Tech Ed Modernization
PM: Meyer Architect: DLR Group Contractor: JOHN F. OTTO INC DBA OTTO CONSTRUCTION
Scope: This Project builds a new 60,552 assignable square feet (asf) (91,000 gross square feet) instructional facility to replace the existing Tech Ed building on the American River College campus. The new building will be used for instruction in Automotive Technology, Welding, Funeral Services and Electronics and provides ADA access compliance and adequate HVAC, power, technology and lighting systems to support these instructional programs. This includes 5,782 asf of lecture space, 50,081 asf of lab space and 4,689 asf of office/admin support. The Project will incorporate existing Tech Ed spaces and surrounding portable buildings, as well as the phased demolition of the existing Tech Ed facility and adjacent portable buildings.
Weekly Update: The project is substantially complete. Commissioning and minor installation of OFCI work continues. Filed NOC for 10-10-2025
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2019 8 Aug 2020 100%
Approvals Aug 2020 1 Sep 2020 100%
Working Drawings Sep 2020 8 May 2021 100%
Approvals May 2021 12 May 2022 100%
Bid and Award May 2022 4 Sep 2022 100%
Construction Sep 2022 34 Jul 2025 100%
Campus Move-in Jul 2025 2 Sep 2025 100%

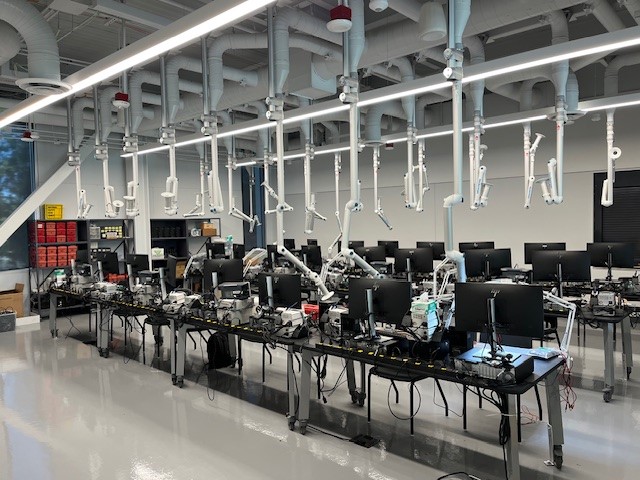

Soldering Lab
View of East Facade
ARC Tech Ed Temp Housing
PM: Meyer Architect: WESTON & ASSOC MECHANICAL ENGINEERS Contractor: DIVISION 5-15 INC
Scope: Modifications to temp housing to accommodate Tech Ed construction phase.
Weekly Update: Contractor has completed installation and balancing of vent system and electrical work required to house program temporarily while the ARC Tech Ed project is under construction. Project is complete.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Aug 2021 1 Sep 2021 100
Approvals Sep 2021 1 Oct 2021 100
Working Drawings Oct 2021 1 Nov 2021 100
Approvals Nov 2021 1 Dec 2021 100
Bid and Award Dec 2021 2 Feb 2022 100
Construction Feb 2022 1 Mar 2022 100
Campus Move-in Mar 2022 0 Mar 2022 100

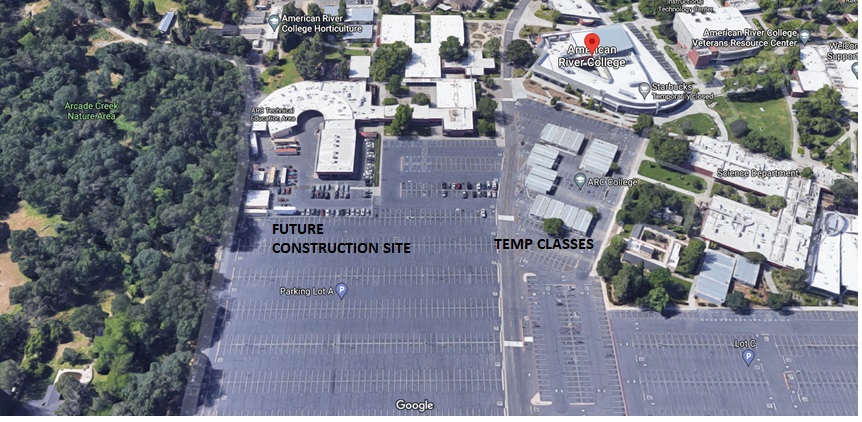

Project location

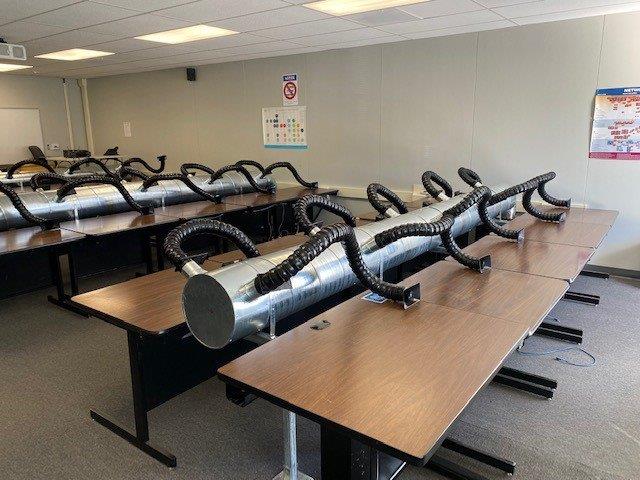

Classroom venting for student projects
ARC Veterans Resource Center
PM: Uhlmeyer Architect: AE3 Contractor:
Scope: This is a Campus funded project to renovate the Veterans Resource Center in the Student Services building. Project demo's existing space, renovates interior to make it more functional and inviting for users and updates HVAC, Electrical, plumbing and all finishes. Also creates new patio area for the program.
Weekly Update: 3/26 - waiting on PO - Preconstruction Meeting to be scheduled for 3/9 at 11am - NTP 4/6 3/19 - NOA issued to Eclipse Pro - working on required DSA Safety Plan with contractor - Scheduled Start Date 3/30 3/10 - Board Agenda item for approval 3/11 with construction to start March 30th 2/23 - Apparent Low Bidder Eclipse Pro for $1,322,260. Purchasing to request contractors' qualifications Plans approved by DSA. Third (final) in-house plan review complete and comments sent to architect on April 11 - Working to coordinate with campus and FM HVAC team for controls work preceding this remodel--this seems to be resolved. Final estimate came in at just under $1.4M. Bid package sent to purchasing for January 16th ad.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2022 3 Mar 2023 100
Approvals Mar 2023 2 May 2023 100
Working Drawings May 2023 9 Feb 2024 100
Approvals Feb 2024 21 Nov 2025 100
Bid and Award Nov 2025 4 Mar 2026 75%
Construction Mar 2026 9 Dec 2026
Campus Move-in Dec 2026 1 Jan 2027
CRC 2025 Central Plant Upgrade
PM: Uhlmeyer Architect: ARCH Nexus - Interface Engineering Contractor:
Scope: Upgrade of central plant heating and chilling equipment to meet current and future capacity needs.
Weekly Update: 3/19 - Project on hold until 3/27 3/11/2026 - Working with Maintenance to evaluate water chemistry within the hydronic loops which will inform final equipment selections, this step is necessary to ensure design team and equipment manufacturers have all pertinent information regarding water running through equipment which will help reduce the potential of future issues; continuing to work on controls package; will schedule page turn with FM Partners as soon as possible.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2025 3 Feb 2026 30%
Approvals Feb 2026 1 Mar 2026
Working Drawings Mar 2026 7 Oct 2026
Approvals Oct 2026 8 Jun 2027
Bid and Award Jun 2027 3 Sep 2027
Construction Sep 2027 14 Nov 2028
Campus Move-in Nov 2028 1 Dec 2028

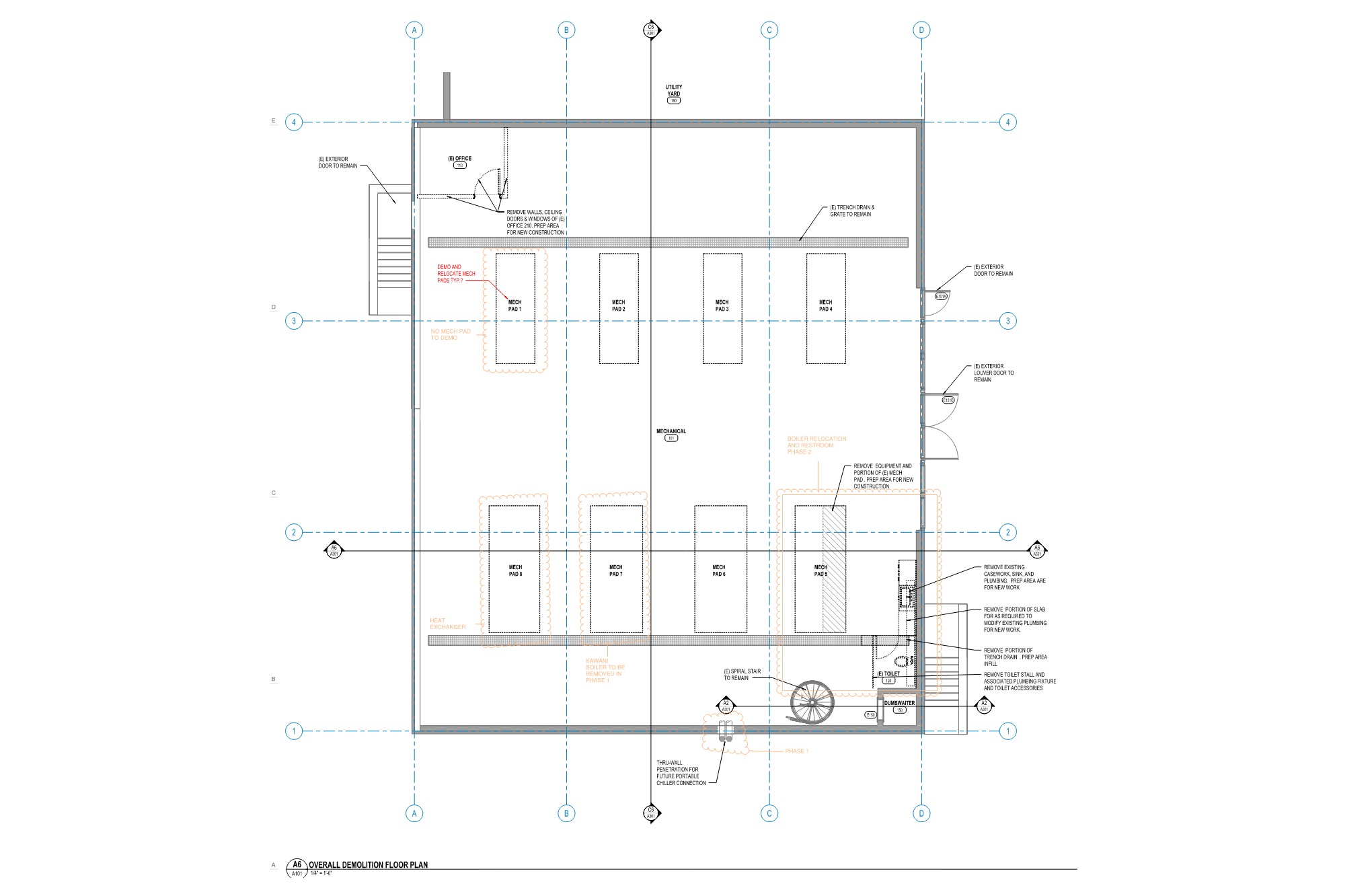

Existing Plant Equipment Layout

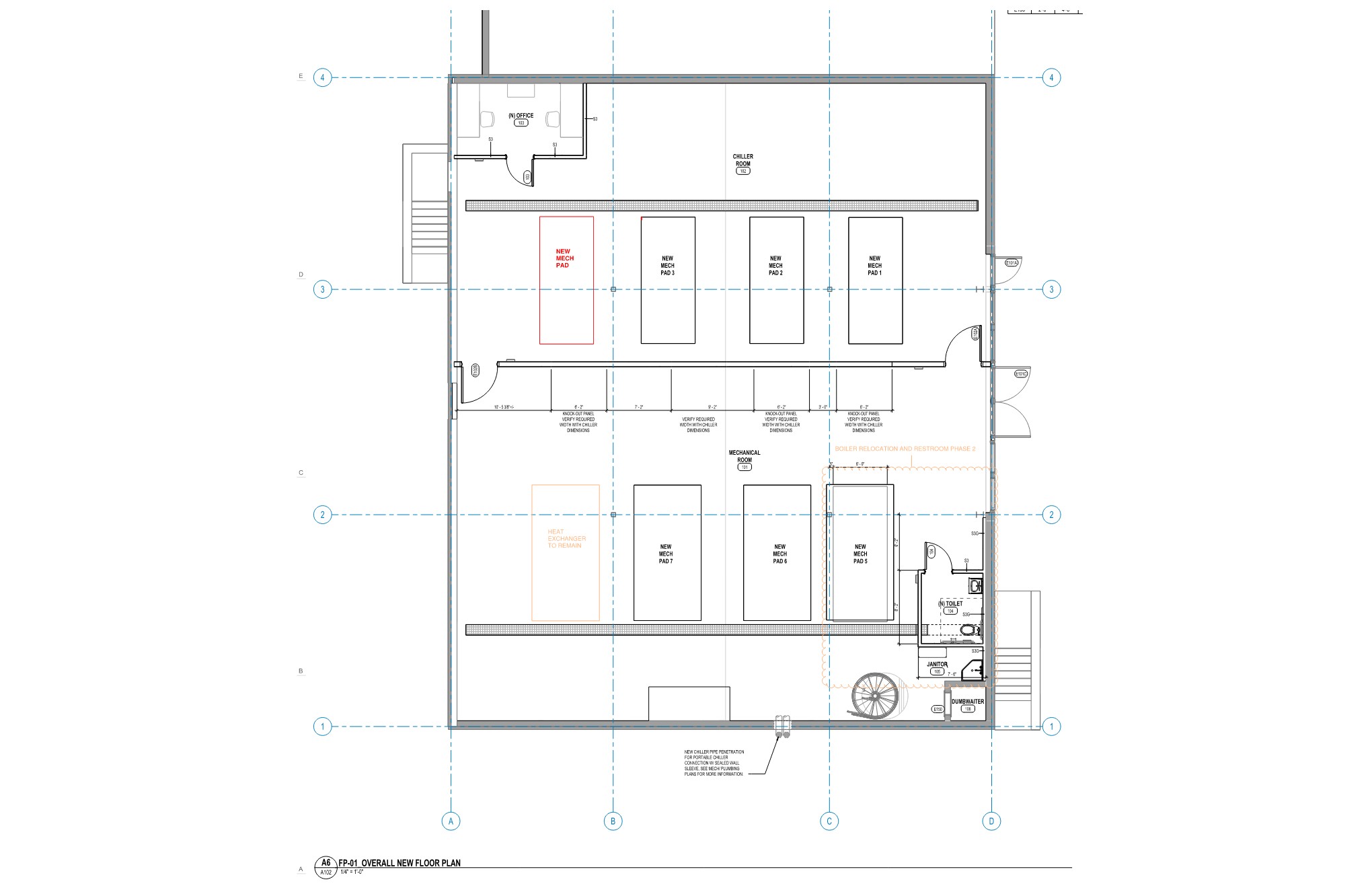

New Plant Layout with ADA Restroom and Expanded Office
CRC 2025 Grounds Relocation
PM: Uhlmeyer Architect: Architechnica Contractor:
Scope: Relocate Campus Grounds facility to area adjacent Receiving prior to CRC Central Plant Upgrade project.
Weekly Update: 3/26 - Survey Schedule pending - Grounds has provided Chemical List with quantities 3/10 - SD set to be delivered 3/16 for review - CEQA Fee Proposal has been submitted 2/23 - SD Design package in in process _ CEQA Fee proposal requested Fee Proposal submitted - need contract COPFD 5600 41 DS.FM.OTHR 71000 70252 077H
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jan 2026 3 Apr 2026
Approvals Apr 2026 1 May 2026
Working Drawings May 2026 1 Jun 2026
Approvals Jun 2026 1 Jul 2026
Bid and Award Jul 2026 2 Sep 2026
Construction Sep 2026 6 Mar 2027
Campus Move-in Mar 2027 1 Apr 2027

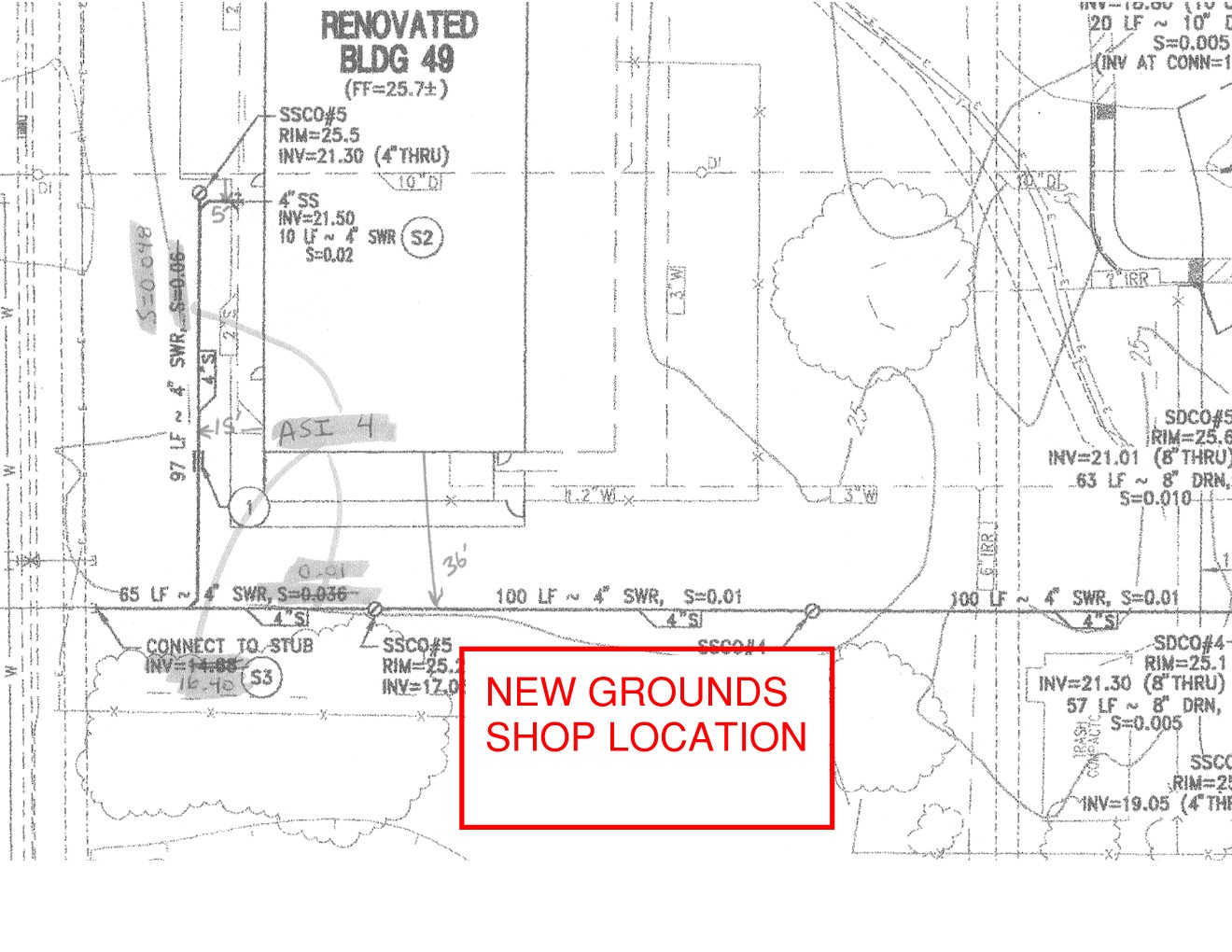

Grounds Shop to relocate

Grounds Shop Relocation
CRC 2025 Stadium Synthetic Turf Replacement
PM: Uhlmeyer Architect: Verde Designs Contractor:
Scope: Project to replace synthetic turf in football stadium which has reached its end of life.
Weekly Update: 3/26 - Field Turf Stadium Submittals are under review - Construction Start Date May 26 2026 3/10 - Field Turf PO has been issued - Submittals under review - Construction Start Date May 26 2026 Negotiating CMAS Contract
Tenative Schedule Start Months Finish % Complete
Prelim Plans Mar 2025 4 Jul 2025 100%
Approvals Jul 2025 1 Aug 2025 100%
Working Drawings Aug 2025 4 Dec 2025 100%
Approvals Dec 2025 2 Feb 2026 100%
Bid and Award Feb 2026 3 May 2026 100%
Construction May 2026 3 Aug 2026
Campus Move-in Aug 2026 1 Sep 2026
CRC Affordable Student Housing
PM: Mirmiran Architect: TCA Architects Contractor:
Scope: Affordable student housing project to be build on campus as CRC. Funds provided by State - $44,100,000 total for hard and soft costs.
Weekly Update: 2026.02.23-Waiting on budget.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2024 16 Mar 2026 10%
Approvals Mar 2026 0 Mar 2026 00%
Working Drawings Mar 2026 9 Dec 2026 00%
Approvals Dec 2026 9 Sep 2027 00%
Bid and Award Sep 2027 4 Jan 2028 00%
Construction Jan 2028 19 Aug 2029 00%
Campus Move-in Aug 2029 2 Oct 2029 00%
CRC CRC Electrical Switch Gear Replacement (SMSR)
PM: Uhlmeyer Architect: The Engineering Enterprise Contractor: BOCKMON & WOODY ELECTRIC CO
Scope:
Weekly Update: 3/19 - Negotiating Final PCO, we are working to keep overall CO's under 10% 3/10 - Final PCO is under review - Meeting scheduled w/ contractor to discuss on 3/11 2/23 - waiting on Bockmon & Woody to provide PCO for permanent Electrical Connection (re-route) 2/23 - ACOD costs for Power outage requested - No Response from Campus 1/30 - Electrical Power has been restored - Classes to resume 2/2 1/27 - New Electrical Gear Failed - caused Campus Wide Electrical Shutdown Contractor performed QC testing of new gear. SMUD inspection passed and requested pre-con with all parties so shut-down date can be established. Medium voltage team worked on install of conductors and testing. letter of acceptance sent to SMUD. Shut down scheduled for 1-11..
Tenative Schedule Start Months Finish % Complete
Prelim Plans Feb 2022 3 May 2022 100
Approvals May 2022 0 May 2022 100
Working Drawings May 2022 13 Jun 2023 100
Approvals Jun 2023 2 Aug 2023 100
Bid and Award Aug 2023 5 Jan 2024 100
Construction Jan 2024 22 Nov 2025 85
Campus Move-in Nov 2025 0 Nov 2025
CRC EGC Phase II
PM: Blake Architect: DLR Group Contractor: JOHN F. OTTO INC DBA OTTO CONSTRUCTION
Scope: The Long Range Capital Needs Plan and local bond measure M include funds to construct Phase 2 of the Elk Grove Center. This Project builds a new 15,200 assignable square feet (asf) (24,888 gross square feet) instructional facility adjacent to the existing Elk Grove Center Phase 1 building. The new building will provide space for instruction in general education, biology and chemistry and provides ADA access compliance and adequate HVAC, power, technology and lighting systems to support these instructional programs. This includes 3,000 asf of lecture space, 7,200 asf of lab space and 2,400 asf of office/admin and 2,600 of miscellaneous student and faculty support space.
Weekly Update: 2026.04.01- 1) Pat with Multistack promised to have all of their outstanding issues with their equipment repaired, up and running per the design intent by end of day Friday 3/20/26, date was pushed out to 3/26, Module 2 still requires repairs. 2) Design team, Multistack, HONEYWELL, Veregy, are all in agreement to install a 3-Way bypass valve on the AHU to increase flow and to rectify ongoing issues with the system, Otto to provide formal submittal.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Sep 2019 8 May 2020 100%
Approvals May 2020 2 Jul 2020 100%
Working Drawings Jul 2020 3 Oct 2020 100%
Approvals Oct 2020 9 Jul 2021 100%
Bid and Award Jul 2021 4 Nov 2021 100%
Construction Nov 2021 26 Jan 2024 100%
Campus Move-in Jan 2024 3 Apr 2024 100%
Lobby
Exterior
CRC Hawk Cares Health and Wellness Mod
PM: Blake Architect: Lionakis Contractor:
Scope: Remodel CRC Bookstore into a basic needs/wellness center and move Hawk Cares (Basic Needs) services and Health and Wellness services into the space.
Weekly Update: 2026.04.01- 1) Total project costs including soft costs estimated at $6,967.683, costs were provided to the site on 3/4/26. 2) Next design meetings scheduled for 4/9/26 & 5/7. 3) Increased LIONAKIS contract P.O. amount for project through closeout.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Sep 2025 6 Mar 2026
Approvals Mar 2026 4 Jul 2026
Working Drawings Jul 2026 3 Oct 2026
Approvals Oct 2026 2 Dec 2026
Bid and Award Dec 2026 4 Apr 2027
Construction Apr 2027 16 Aug 2028
Campus Move-in Aug 2028 1 Sep 2028
DOC District Wide Infrastructure Master Planning
PM: Meyer Architect: Contractor:
Scope: District Wide Infrastructure Master Planning
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jan 2014 6 Jun 2014 0%
Approvals Jun 2014 4 Oct 2014 0%
Working Drawings Oct 2014 7 May 2015 0%
Approvals May 2015 7 Dec 2015 0%
Bid and Award Dec 2015 3 Mar 2016 0%
Construction Mar 2016 22 Dec 2017 0%
Campus Move-in Dec 2017 4 Apr 2018 0%
DOC DO Bond Admin
PM: Meyer Architect: Contractor:
Scope: Project to capture expenses associated with managing the Bond Program
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jul 2022 2 Sep 2022 0%
Approvals Sep 2022 0 Sep 2022 0%
Working Drawings Sep 2022 4 Jan 2023 0%
Approvals Jan 2023 3 Apr 2023 0%
Bid and Award Apr 2023 4 Aug 2023 0%
Construction Aug 2023 6 Feb 2024 0%
Campus Move-in Feb 2024 1 Mar 2024 0%
DOC LRPD Move to FM
PM: Uhlmeyer Architect: HED Contractor: MESA ENERGY SYSTEMS INC
Scope: Relocate LRPD from Ethan Way to Facilities Management, to include emergency generator & UPS backup, HVAC/Electrical/Data upgrades as needed and warehouse revisions necessary to make room for TI.
Weekly Update: 3/19 - Chief Woo has asked to change "evidence room" to Office 3/10 - Need 20 yr. fire sprinkler test for Fire Marshal sign off (FM) - PD OK to move 2/23 - Final County Inspections are scheduled - TCO expected Generator Startup scheduled for week of March 2nd Waiting on Electrical Panels (expected December 10) to complete project Frame, Drywall, rough plumbing complete - electrical ongoing- interior/exterior painting (prime & first coat) structured cabling to start 10/2/2025. Still do not have auto gate approval. Precon meeting 6/2 Conditional NTP issued for 6/2 - Unconditional NTP released 6/4
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jan 2023 11 Dec 2023 100%
Approvals Dec 2023 2 Feb 2024 100%
Working Drawings Feb 2024 3 May 2024 100%
Approvals May 2024 9 Feb 2025 100%
Bid and Award Feb 2025 4 Jun 2025 100%
Construction Jun 2025 8 Feb 2026 99%
Campus Move-in Feb 2026 1 Mar 2026
DOC Synthetic Field Turf Replacement, FLC, SCC
PM: Uhlmeyer Architect: Verde Design Contractor:
Scope: Replacing field turf, football/soccer, at FLC and SCC
Weekly Update: SCC pre-con on 4/25 - when well..........FLC Pre-con scheduled 5/4 ........................................................................................................ SCC Hughes Stadium project is funded and PO has been submitted - PO needs to be issued on or before 3/31 to maintain completion schedule of July 25. FLC Soccer PO has been submitted - FLC matching augmentation funds required for PO to be approved
Tenative Schedule Start Months Finish % Complete
Prelim Plans Mar 2022 4 Jul 2022 100%
Approvals Jul 2022 0 Jul 2022 100%
Working Drawings Jul 2022 4 Nov 2022 100%
Approvals Nov 2022 2 Jan 2023 100
Bid and Award Jan 2023 3 Apr 2023 100
Construction Apr 2023 3 Jul 2023 100%
Campus Move-in Jul 2023 0 Jul 2023 100%
DOC Test Contractor Delete Issue Project
PM: Architect: Contractor:
Scope:
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Oct 2025 1 Nov 2025
Approvals Nov 2025 1 Dec 2025
Working Drawings Dec 2025 1 Jan 2026
Approvals Jan 2026 1 Feb 2026
Bid and Award Feb 2026 1 Mar 2026
Construction Mar 2026 5 Aug 2026
Campus Move-in Aug 2026 0 Aug 2026
FLC 2026 Innovation Center
PM: Mirmiran Architect: AEDIS Contractor:
Scope:
Weekly Update: 2026.03.24-a Team meeting is due to discuss HVAC issues in this building. Waiting for A/E's coordination.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2025 4 Apr 2026 50%
Approvals Apr 2026 1 May 2026 00%
Working Drawings May 2026 2 Jul 2026 00%
Approvals Jul 2026 4 Nov 2026 00%
Bid and Award Nov 2026 3 Feb 2027 00%
Construction Feb 2027 6 Aug 2027 00%
Campus Move-in Aug 2027 0 Aug 2027 00%
FLC Central Plant Upgrades
PM: Meyer Architect: Interface Contractor: RODAN BUILDERS, INC
Scope: Upgrade of Central Plant heating and cooling quality and capacity to accommodate near and long term building needs.
Weekly Update: 2026.3.16: Project is approximately 90% complete. Heating side boilers and pump installation complete. Cooling towers installed and water passivisation in progress; replacement VSD's for the chillers have been shipped two times and have not been received in usable conidition, currently being told VSD's will arrive in mid to late April; project completion will follow. Temp chiller is in place for use until permanent chillers are working and have been commissioned.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2020 9 Aug 2021 100
Approvals Aug 2021 7 Mar 2022 100
Working Drawings Mar 2022 7 Oct 2022 100
Approvals Oct 2022 9 Jul 2023 100
Bid and Award Jul 2023 8 Mar 2024 100
Construction Mar 2024 25 Apr 2026 90
Campus Move-in Apr 2026 1 May 2026 85

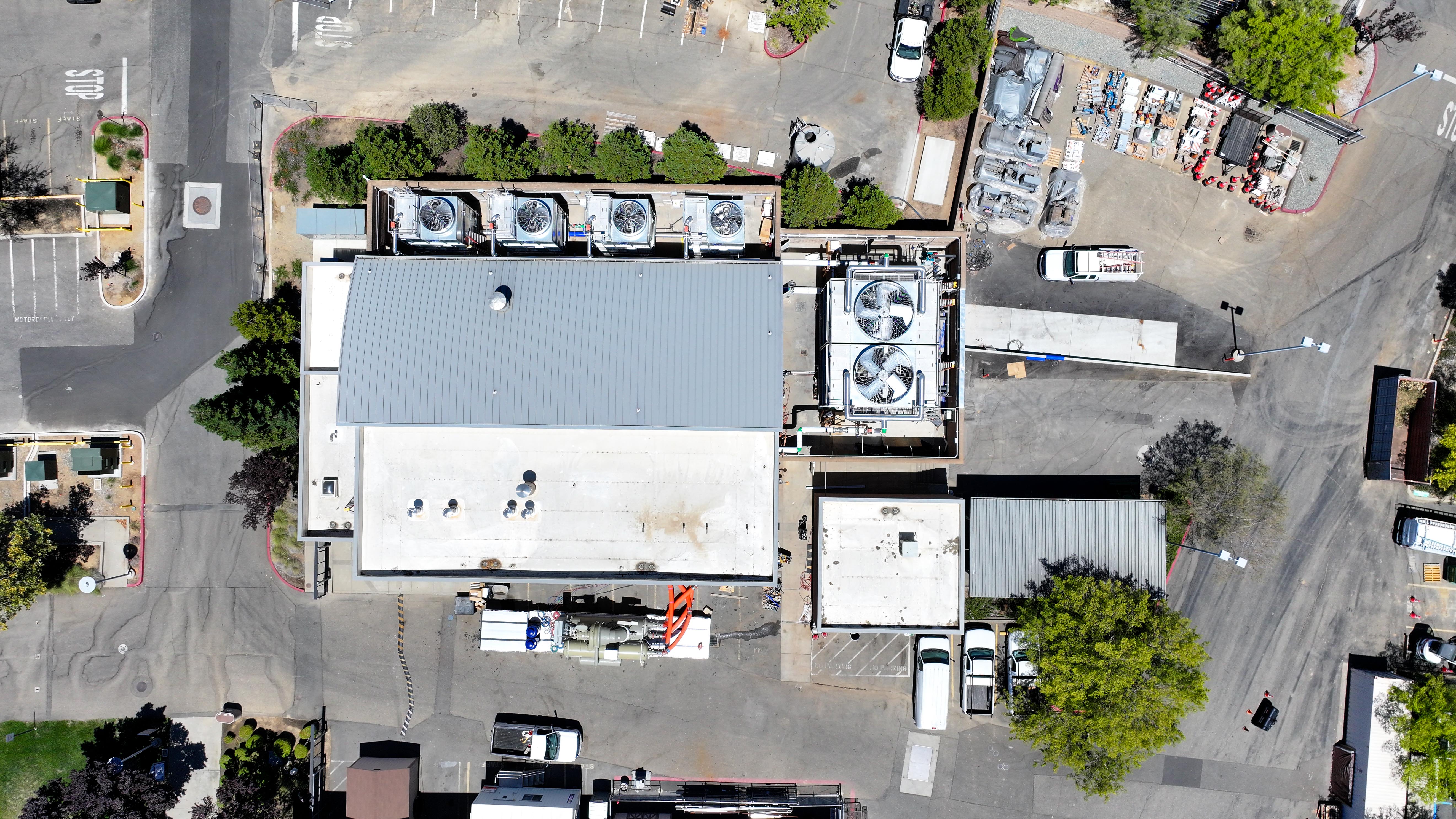

CUP Aerial View
Cooling Tower 1-4 Yard
FLC Rancho Center Health Hub Project
PM: Meyer Architect: Lionakis Contractor: NYECON INC
Scope: Project will remodel a portion of the Rancho Cordova Ctr Phase 1 building for new Health programs - CN, EMT & Radiology Tech.
Weekly Update: Bid date 5/15/2025.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jul 2024 1 Aug 2024
Approvals Aug 2024 1 Sep 2024
Working Drawings Sep 2024 2 Nov 2024
Approvals Nov 2024 3 Feb 2025
Bid and Award Feb 2025 5 Jul 2025
Construction Jul 2025 3 Oct 2025
Campus Move-in Oct 2025 1 Nov 2025
FLC Rancho Cordova Phase 2 Parking
PM: Uhlmeyer Architect: Studio W Contractor: CREEKSIDE COMMERCIAL BUILDERS INC
Scope: Construction of additional off site parking to support Rancho Cordova Center. Project will expand parking lot across Paseo Drive, a short walk to the Rancho Cordova Center, and provide approximately 66 additional stalls.
Weekly Update: 3/19 - lights replacement is moving forward - submittals expected 3/27 3/10 - Parking lot lights to be replaced at Architects expense - Board Agenda Item scheduled for 3/11 - upon approval CABAR will release Light Pole Submittals.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Jul 2022 1 Aug 2022 100
Approvals Aug 2022 3 Nov 2022 100
Working Drawings Nov 2022 3 Feb 2023 100
Approvals Feb 2023 3 May 2023 100
Bid and Award May 2023 2 Jul 2023 100
Construction Jul 2023 18 Jan 2025 100
Campus Move-in Jan 2025 0 Jan 2025 100
Parking Lot Expansion Paving Complete
New Electrical Gear
FLC Science 2.1
PM: SixthDimension Architect: HMC Contractor: JOHN F OTTO, INC
Scope: This Project builds a new 48,900 assignable square feet (asf) (75,000 gross square feet) science building. The new building will be used for instruction in general education, biology and chemistry and provides ADA access compliance and adequate HVAC, power, technology and lighting systems to support these instructional programs. This includes 8,800 asf of lecture space, 28,900 asf of lab space and 11,200 asf of office/admin support. The project will also construct 138 new parking spaces, including 8 new electrical vehicle charging stations (EVCS) in existing parking in front of the Harris Center.
Weekly Update: Project is complete; Campus has occupied and is using the facility. Contractor is addressing warranty issues.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2019 9 Sep 2020 100
Approvals Sep 2020 2 Nov 2020 100
Working Drawings Nov 2020 7 Jun 2021 100
Approvals Jun 2021 13 Jul 2022 100
Bid and Award Jul 2022 4 Nov 2022 100
Construction Nov 2022 34 Sep 2025 100
Campus Move-in Sep 2025 4 Jan 2026 100
Chemistry Collaborative Space
Main Entrance
SCC 2024 Quad Lighting
PM: Mirmiran Architect: Engineering Enterprise Contractor:
Scope: Replace exterior pole lights around quad and campus with new energy efficient LED pole lights.
Weekly Update: 2026.03.24-Second bid in progress, bid opening 03/24, Board Approval 04/08, construction start 06/15
Tenative Schedule Start Months Finish % Complete
Prelim Plans Dec 2024 4 Apr 2025 100%
Approvals Apr 2025 1 May 2025 100%
Working Drawings May 2025 2 Jul 2025 100%
Approvals Jul 2025 4 Nov 2025 100%
Bid and Award Nov 2025 7 Jun 2026 50%
Construction Jun 2026 2 Aug 2026 0%
Campus Move-in Aug 2026 1 Sep 2026 0%
SCC 2025 Bookstore Renovation
PM: Meyer Architect: Contractor:
Scope: Campus funded project to renovate the bookstore. Phase 1 includes programming efforts only.
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2025 0 Nov 2025
Approvals Nov 2025 0 Nov 2025
Working Drawings Nov 2025 0 Nov 2025
Approvals Nov 2025 0 Nov 2025
Bid and Award Nov 2025 0 Nov 2025
Construction Nov 2025 0 Nov 2025
Campus Move-in Nov 2025 0 Nov 2025
SCC Astroturf Synthetic Softball Field
PM: Uhlmeyer Architect: LPA Contractor: PROGRASS WEST INC
Scope: In an effort to address sustainability goals and improve facilities for Los Rios students this project will replace the exis t ing natural grass softball fields at American River College, Sacramento City College and Folsom Lake College with a new synthetic fields. The planned improvements include Removal of the existing natural grass field, New synthetic turf field with associated subdrainage, ADA path of travel improvements as required for the field and Minor ADA improvements to the existing restroom facilities.
Weekly Update: 3/10 - DSA Final Fees have been submitted- the check will be hand carried to DSA to close this project Field complete - ADA Restroom work at Union Stadium start January 6, 2025 with expected completion January 26, 2025
Tenative Schedule Start Months Finish % Complete
Prelim Plans May 2022 4 Sep 2022 100%
Approvals Sep 2022 1 Oct 2022 100%
Working Drawings Oct 2022 2 Dec 2022 100%
Approvals Dec 2022 3 Mar 2023 100%
Bid and Award Mar 2023 3 Jun 2023 100%
Construction Jun 2023 6 Dec 2023 100%
Campus Move-in Dec 2023 0 Dec 2023 100%
SCC Child Development Center Shade Structure
PM: Mirmiran Architect: KYA Contractor: KYA SERVICES LLC
Scope: Campus funded project
Weekly Update: 2026.03.24-PH I of construction completed, PH II, installation of PIP to follow on May 5/22 through 06/05.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Oct 2025 1 Nov 2025 100%
Approvals Nov 2025 0 Nov 2025 100%
Working Drawings Nov 2025 0 Nov 2025 100%
Approvals Nov 2025 1 Dec 2025 100%
Bid and Award Dec 2025 3 Mar 2026 100%
Construction Mar 2026 2 May 2026 50%
Campus Move-in May 2026 0 May 2026 0%
SCC PAC Main Speaker Replacement
PM: Blake Architect: Moniz Architecture Contractor:
Scope: Replace main speakers in PAC that have failed. Speakers hang from above and project will require engineering and DSA approval.
Weekly Update: 2026.04.01- 1) Received two quotes, BP Interiors-$520,493, Pro Builders-$334,800, both exceed the Small Business Threshold of $250,000. 2) Put the project out to Hard Bid, ADS- 4/3 & 4/10, Bid Walk Scheduled for 4/15, Bid Opening scheduled for 4/23, estimated value of project $320,000, project does not have to go to the board due to the value is under $499,000/Board Ratification.
Tenative Schedule Start Months Finish % Complete
Prelim Plans Feb 2025 6 Aug 2025
Approvals Aug 2025 3 Nov 2025
Working Drawings Nov 2025 2 Jan 2026
Approvals Jan 2026 2 Mar 2026
Bid and Award Mar 2026 3 Jun 2026
Construction Jun 2026 2 Aug 2026
Campus Move-in Aug 2026 1 Sep 2026
SCC Sand Volleyball
PM: Meyer Architect: Contractor:
Scope: Conceptual Design
Weekly Update:
Tenative Schedule Start Months Finish % Complete
Prelim Plans Aug 2025 0 Aug 2025
Approvals Aug 2025 0 Aug 2025
Working Drawings Aug 2025 0 Aug 2025
Approvals Aug 2025 0 Aug 2025
Bid and Award Aug 2025 0 Aug 2025
Construction Aug 2025 0 Aug 2025
Campus Move-in Aug 2025 0 Aug 2025
SCC SCC South Loop Chiller Replacement (SMSR)
PM: Uhlmeyer Architect: Studio W Architecture Contractor: BP INTERIORS INC
Scope: The SCC South Chiller Replacement project will Demo / remove existing “end of life” (EOL) chiller and associated chilled water piping & existing (refrigerant) evacuation/alarm system, install a new Chiller in its place as well as replace exiting pumps, VFD's and existing Chilled Water Piping/Valves as required • Replace Honeywell Controls System • Replace existing (refrigerant) evacuation/alarm system
Weekly Update: 3/19 - (new pumps. VDF’s & Increased Pipe Size) - project on hold due to seasonal / nature of work 3/10 - Contract to correct flow issues has been issued to EMCOR - new pumps lead time has postponed the construction. Outstanding issue - Honeywell to provide corrected As-builts
Tenative Schedule Start Months Finish % Complete
Prelim Plans Nov 2022 2 Jan 2023 100%
Approvals Jan 2023 0 Jan 2023 SD 100%
Working Drawings Jan 2023 4 May 2023 100%
Approvals May 2023 4 Sep 2023 100%
Bid and Award Sep 2023 3 Dec 2023 100%
Construction Dec 2023 4 Apr 2024 99%
Campus Move-in Apr 2024 0 Apr 2024
SCC Security Improvement Project - Phase 1 Hardware/Cylinders/Keys
PM: Meyer Architect: Meyer Contractor: BOBO CONSTRUCTION, INC.
Scope: This project has responsibility to provide and install physical door hardware both electrified and non-electrified campus wide. This project will also install owner provided cylinders
Weekly Update: 2023-1-5: Rec'd Midstate PO on 1/4, will coordinate remaining install with Campus. 2022-12-13: Submitted on PO for Midstates and will be completing final buildings in early 2023. 2022-11-16: Working on getting a new PO for Midstate to complete the remaining work in Jan. 2022-8-25: Have substantially completed installation of bypass cores in most buildings, only Lusk, N. Gym Cafeteria and miscellaneous locations remain.
Tenative Schedule Start Months Finish % Complete
Prelim Plans May 2018 3 Aug 2018 100
Approvals Aug 2018 1 Sep 2018 100
Working Drawings Sep 2018 2 Nov 2018 100
Approvals Nov 2018 1 Dec 2018 100
Bid and Award Dec 2018 3 Mar 2019 100
Construction Mar 2019 34 Jan 2022 100
Campus Move-in Jan 2022 1 Feb 2022 100
Hardware awaiting key cylinder install
Building keybox
SCC Swing Space Portable Removal
PM: Blake Architect: N/A Contractor: SIERRA EXCAVATING LLC
Scope: This project will remove all remaining swing space portable buildings on Campus with the exception of one that will house bathrooms and provide storage space for Campus.
Weekly Update: 2026.04.01- 1) Received parking lot striping drawings from Engineer; working on Bid walk for Striping Project in April. 2) EMCOR poured foundations for lights on 3/18, ordered lights on 2/20, will be installed once received (18 week lead time).
Tenative Schedule Start Months Finish % Complete
Prelim Plans Oct 2024 0 Oct 2024 100
Approvals Oct 2024 0 Oct 2024 100
Working Drawings Oct 2024 0 Oct 2024 100
Approvals Oct 2024 15 Jan 2026 100
Bid and Award Jan 2026 1 Feb 2026 100
Construction Feb 2026 5 Jul 2026 50
Campus Move-in Jul 2026 1 Aug 2026

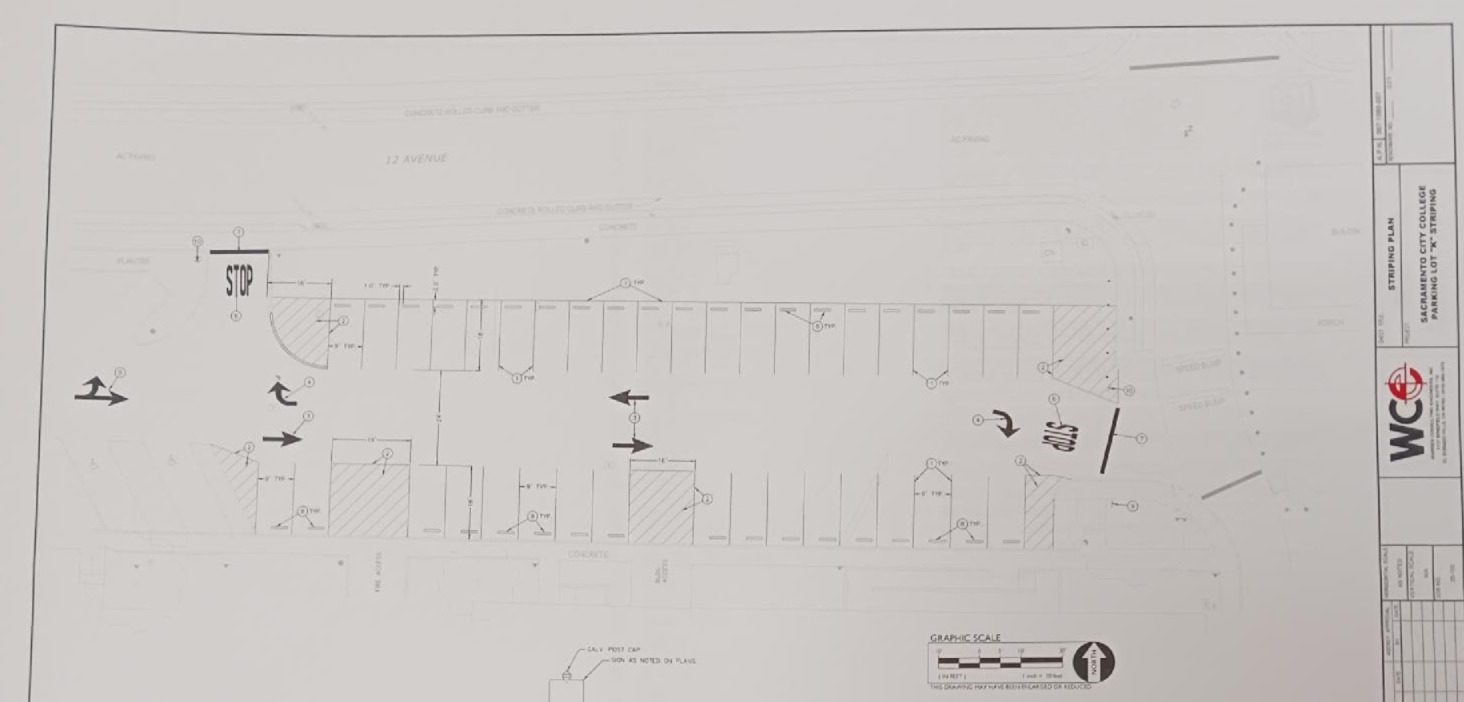

Striping Plan
Solar Light
